Pre-Pour Inspection

Foundation Phase Inspection • Before Concrete Placement

Checks foundation forms, rebar placement, plumbing penetrations, and grading before concrete is poured. The goal is to catch issues while they're still straightforward to fix — before the slab locks everything in place.

Schedule OnlineCall 713-324-7777

When it occurs

Not sure when to schedule? See when to schedule a pre-pour inspection.

Timing: before the slab is poured — after foundation preparation is sufficiently complete to inspect, but before concrete placement.

Pre-pour work is evaluated against applicable building codes for foundation and underground plumbing at this stage. I hold ICC R5 (Residential Combination Inspector) certification and am a TREC Professional Inspector #24271.

What's observable before the pour

At this stage, I can typically observe and document:

  • Form placement and alignment
  • Form elevation — checked with a Zip Level® before the pour, while differences can still be identified and addressed
  • Reinforcing steel (rebar) size, spacing, and placement
  • Plumbing penetrations and stub-outs before they're buried
  • Vapor/moisture barrier presence and condition, where used
  • Site grading and drainage slope around the forms
  • General sub-grade/soil prep conditions visible prior to the pour

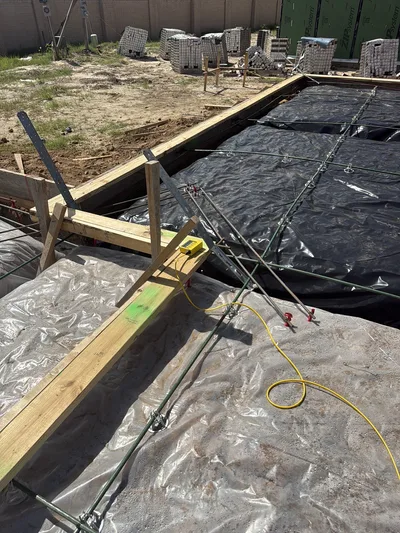

Zip Level elevation-measurement device set up on a foundation form before a concrete pour.
Checking form elevation with a Zip Level® before the pour — the last practical chance to catch and correct differences before concrete sets the finished grade.

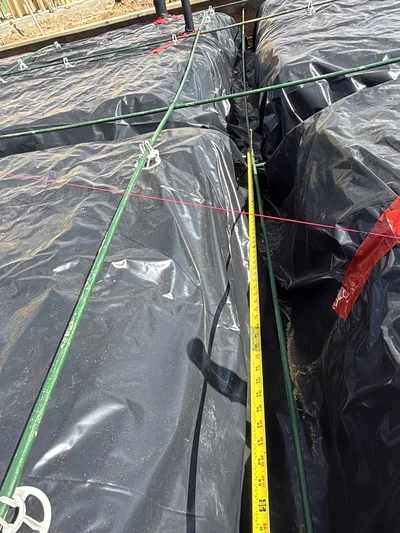

Tape measure checking post-tension cable spacing over a vapor barrier before concrete placement.
Checking tendon spacing before the pour.

Plumbing pipe penetration sealed with tape through a vapor barrier before a concrete pour.
A plumbing penetration through the vapor barrier — visible now, buried once concrete is placed.
PVC plumbing runs over a vapor barrier and rebar grid before a slab pour.
Plumbing isolation from concrete at slab penetrations — under-slab conditions documented before the pour.
Horizontal rebar end near foundation form lumber with insufficient clearance for concrete cover.
Rebar too close to the form — adequate edge cover is required; correctable while the foundation is still open.
Rebar cage over a vapor barrier with a lower member lacking adequate support.
Unsupported or inadequately supported rebar at a cage detail — support and clearance are reviewed before concrete placement.
New slab rebar grid adjacent to an existing foundation without dowels tying to the existing wall.
New foundation rebar at an existing wall without pinning per plans — connection details are verifiable only before the pour.

What becomes concealed after concrete placement

Once concrete is placed, these conditions are no longer observable:

  • Rebar position and coverage within the slab
  • Condition and placement of any vapor barrier or under-slab insulation
  • Under-slab plumbing runs and conduit/utility routing
  • Sub-grade soil conditions directly beneath the slab

That's why timing matters — and why a pre-pour inspection is a distinct opportunity from a later phase or a final inspection.

Examples from actual pre-pour inspections

A few conditions from inspections I've performed — the kind of thing that's visible now and won't be after the pour.

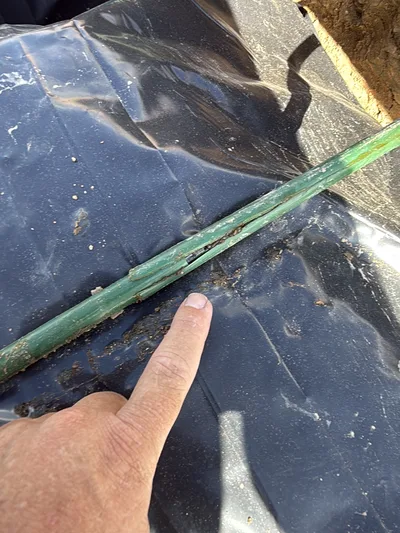

Close-up of torn sheathing on a post-tension cable before a concrete pour.
Damaged protective sheathing on a post-tension tendon. Exposed sheathing lets concrete bond directly to the tendon, which can interfere with proper tensioning. This was flagged for repair while the tendon was still accessible — not something you can catch once concrete is placed.

Rebar dowels crossing at a foundation edge form before a concrete pour.
A missing tie wire at a rebar intersection. Reinforcing steel needs to stay tied in position for the pour — this could be corrected while it was still accessible, before concrete locked it in place.

Scheduling and builder coordination

The builder controls the construction schedule and tells you when the home is ready for a pre-pour inspection. You coordinate the inspection window with the builder. Contact me as soon as the builder provides that window — I need access after foundation preparation is ready but before concrete is poured.

Pricing

Pre-pour inspections use the same home-inspection pricing model — starting at $230+ for homes up to 1,500 sq ft and less than 2 years old. See inspection pricing for details.

Limitations

A pre-pour inspection is not an engineering analysis, design verification, structural certification, or code-official authority inspection. It does not guarantee future foundation performance. I document observable conditions at this stage from the buyer's perspective.

← New construction inspections overview · Pre-drywall inspection (next opportunity if you haven't had one yet)

FAQs

What is checked during a pre-pour inspection?

Pre-pour checks typically include foundation form work, rebar placement, plumbing penetrations, and grading/drainage setup before the concrete is poured.

When should a pre-pour inspection happen?

Ideally, as soon as you're under contract — see when to schedule a pre-pour inspection for the full process. The inspection itself happens once foundation preparation is substantially complete and before concrete is placed.

Why should I get a pre-pour inspection before the concrete is poured?

A pre-pour inspection in the Houston area gives you a chance to observe and document foundation preparation while reinforcing steel, plumbing penetrations, vapor barrier conditions, form placement, and other visible details are still accessible. After concrete is placed, many of those conditions can no longer be directly observed, and corrections that are comparatively straightforward before the pour become more difficult once the slab conceals the work. See new construction inspections for how the pre-pour phase fits the overall build.

What does a pre-pour inspector look for in the foundation?

During a pre-pour inspection, GreenLight Inspections reviews visible foundation preparation, including form placement and alignment, form elevation (checked with a Zip Level®), reinforcing steel size, spacing, and placement, plumbing penetrations and stub-outs, vapor or moisture barrier condition where used, grading, and visible sub-grade conditions. Reinforcing steel support, clearance, and placement can be evaluated while the foundation remains open.

Do you compare the foundation to the engineered foundation plans?

Yes, when applicable foundation plans are available at the site or otherwise provided for the inspection, GreenLight compares observable field conditions with relevant information shown on the engineered foundation plan and notes. That comparison supports the inspection but does not turn the service into engineering analysis, structural design verification, or structural certification.

Can a pre-pour inspection find problems with rebar or post-tension tendons?

Yes. Observable reinforcement conditions can be evaluated before the pour, including rebar placement, spacing, support and clearance, connection details shown on available plans, and visible post-tension tendon conditions such as spacing or damaged protective sheathing. A pre-pour inspection does not perform engineering calculations or certify the structural design.

What happens if a problem is found during a pre-pour inspection?

Observable conditions are documented in the inspection report so the buyer can discuss them with the builder while the foundation is still accessible. The builder and its appropriate contractors or design professionals determine and perform any required corrections. Identifying concerns before concrete placement can make verification and correction more practical because the work has not yet been concealed. The next common construction-phase opportunity after the slab is often a pre-drywall inspection.

Is a pre-pour inspection the same as a foundation engineering inspection?

No. A GreenLight pre-pour inspection evaluates observable construction conditions at that stage and applicable building-code issues within the inspection scope. It is not an engineering analysis, structural design verification, structural certification, or guarantee of future foundation performance. Consult a licensed engineer when engineering analysis, design changes, structural calculations, or a professional engineering certification is required.
